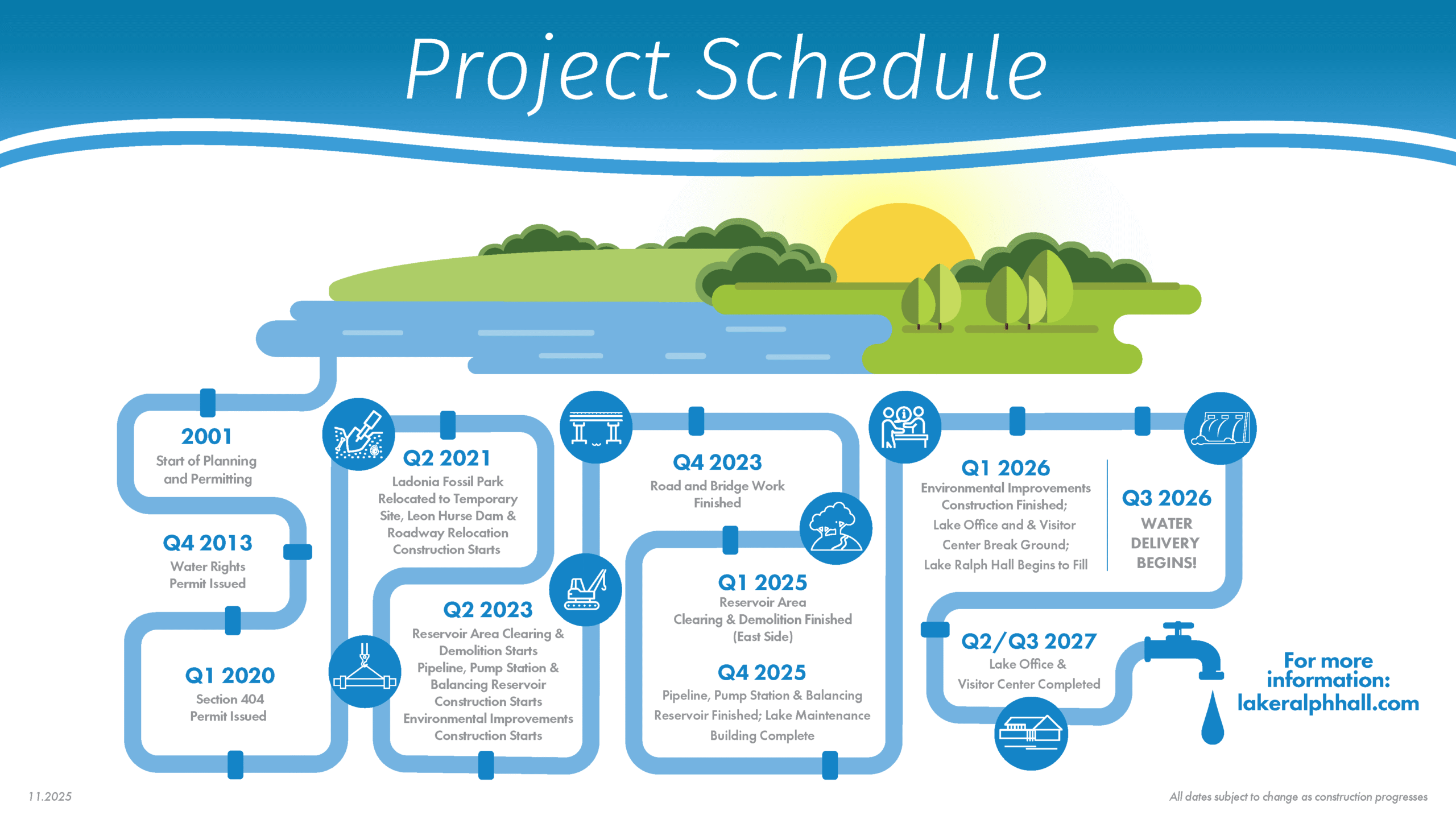

Project Schedule Home 9 Project Schedule Lake Ralph Hall has been decades in the making, with its first permit filed in 2003. The reservoir broke ground in early 2021 and began filling in July 2026. See below for a full project schedule broken down by its different components. Download the Project Schedule
